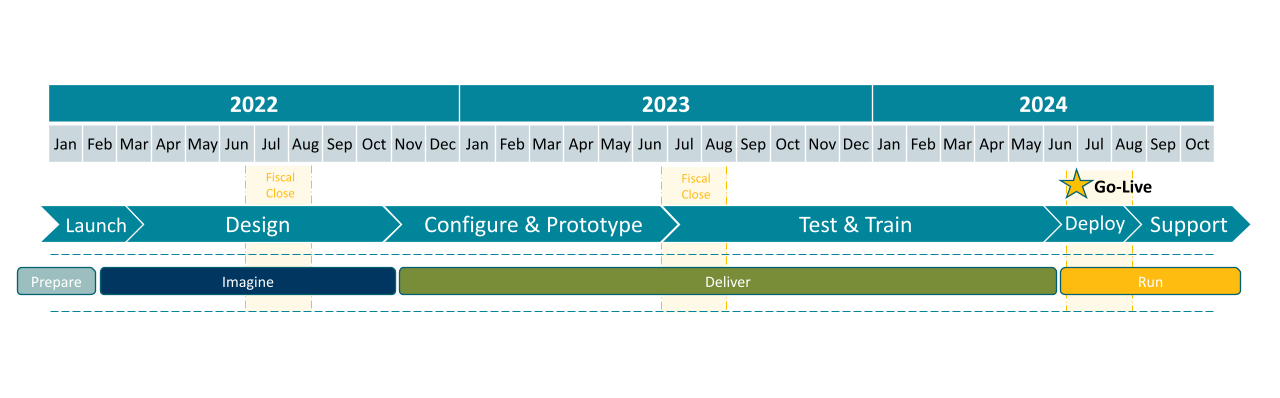

The Financial Management Modernization Program consists of seven major phases:
Prepare Phase (not pictured - completed February 2022)
-
Define the scope of the project
-
Complete project charter
Launch Phase (not pictured - completed March 2022)
-
Establish project governance
-
Define project structure
-
Deploy tools and processes for managing the project
Design Phase (completed January 2023)
-
Identify user personas to approach process design from the user’s perspective
-
Conduct process design sessions with the objective of defining the integrated business process model
-
Document user stories
-
Sustainment planning
Configure and Prototype Phase (completed December 2023)
-
Build Environment
-
Data conversion
Test Phase
-
Data validation
-
Systems Integration Testing
-
User Acceptance Testing
Deploy Phase
-
System and business cutover
-
End-user training
-
Go/no-go evaluations
-
Transition to the sustainment organization
Run Phase
-
Go-live
-
Hypercare
-
Stabilization
